Search Gas Turbine Power for Data Center Publications search was updated real-time via Filemaker on:
Search Completed | Title | Applying Natural Gas Engine Generators to Hyperscale Data Centers
Original File Name Searched: WP286V1.pdf | Google It | Yahoo | Bing

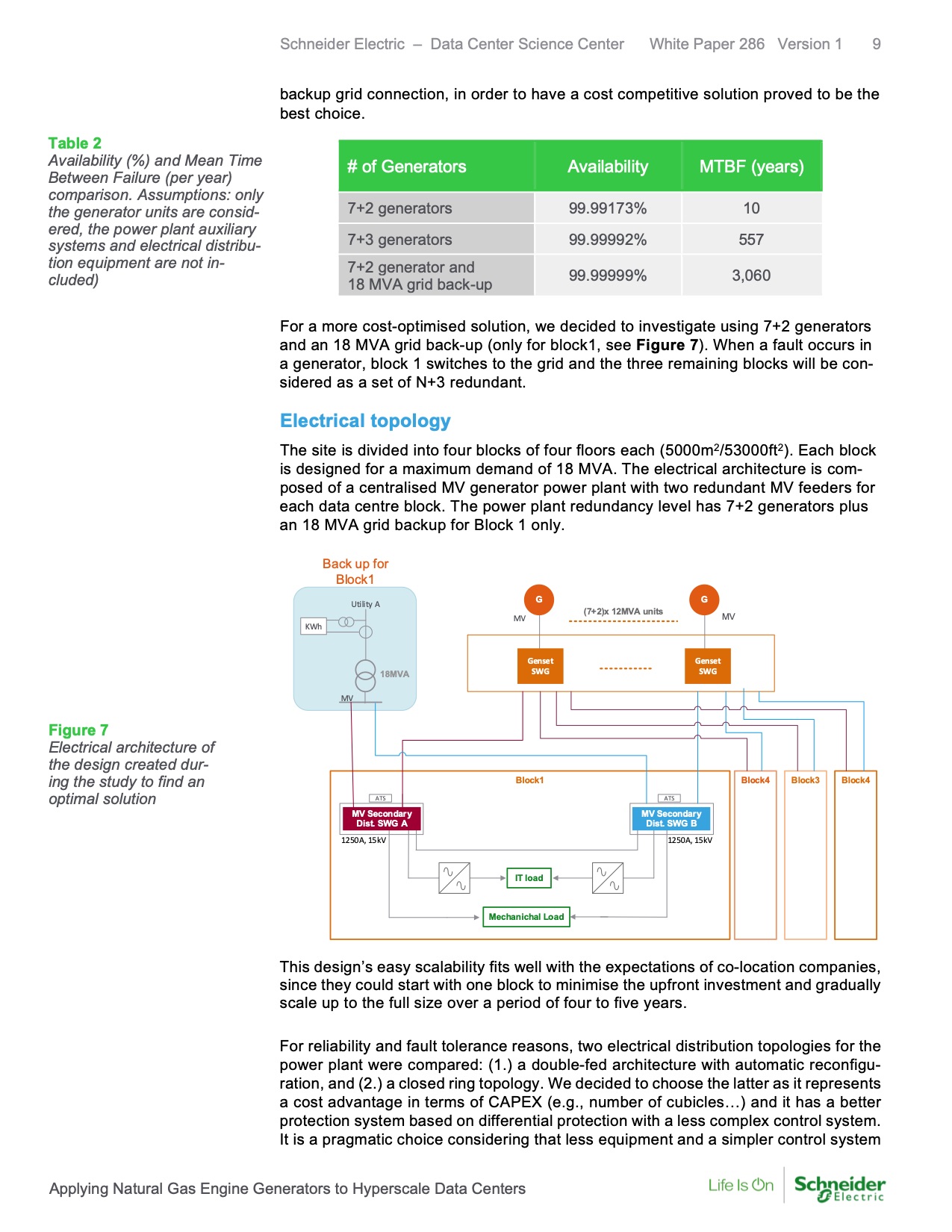

Page | 009 Schneider Electric – Data Center Science Center White Paper 286 Version 1 9 backup grid connection, in order to have a cost competitive solution proved to be the best choice. Table 2 Availability (%) and Mean Time Between Failure (per year) comparison. Assumptions: only the generator units are consid- ered, the power plant auxiliary systems and electrical distribu- tion equipment are not in- cluded) # of Generators Availability MTBF (years) 7+2 generators 99.99173% 10 7+3 generators 99.99992% 557 7+2 generator and 99.99999% 3,060 18 MVA grid back-up For a more cost-optimised solution, we decided to investigate using 7+2 generators and an 18 MVA grid back-up (only for block1, see Figure 7). When a fault occurs in a generator, block 1 switches to the grid and the three remaining blocks will be con- sidered as a set of N+3 redundant. Electrical topology The site is divided into four blocks of four floors each (5000m2/53000ft2). Each block is designed for a maximum demand of 18 MVA. The electrical architecture is com- posed of a centralised MV generator power plant with two redundant MV feeders for each data centre block. The power plant redundancy level has 7+2 generators plus an 18 MVA grid backup for Block 1 only. Back up for Block1 G G Utility A (7+2)x 12MVA units MV MV KWh 18MVA Genset SWG Genset SWG MV Figure 7 Electrical architecture of the design created dur- ing the study to find an optimal solution Block1 Block4 Block3 Block4 ATS ATS MV Secondary Dist. SWG A MV Secondary Dist. SWG B 1250A, 15kV 1250A, 15kV IT load Mechanichal Load This design’s easy scalability fits well with the expectations of co-location companies, since they could start with one block to minimise the upfront investment and gradually scale up to the full size over a period of four to five years. For reliability and fault tolerance reasons, two electrical distribution topologies for the power plant were compared: (1.) a double-fed architecture with automatic reconfigu- ration, and (2.) a closed ring topology. We decided to choose the latter as it represents a cost advantage in terms of CAPEX (e.g., number of cubicles…) and it has a better protection system based on differential protection with a less complex control system. It is a pragmatic choice considering that less equipment and a simpler control system Applying Natural Gas Engine Generators to Hyperscale Data Centers |
